What Is an IT Roadmap? (And How a vCIO Builds One)

Last updated: 08/11/2026
IT and Business Operations

An IT roadmap is a dated, budgeted plan that lists every technology project a company will run over the next 12 to 36 months, why each one is on the list, and what it costs. A vCIO builds it from an assessment of your current environment, your business goals, and your risk register. It gets reviewed every quarter. Without dollars and owners attached, it's a wish list.

Your provider hands you a deck once a quarter. Colored bars, a few logos, the word Roadmap on top. Then December arrives and three of the four projects never happened, because a server died in March and the money went there. That isn't a planning failure. It's a document that was never a plan. The real version is what vCIO services exist to build.

You'll see McKinsey's number quoted on nearly every page about this topic. Large IT projects run 45% over budget and deliver 56% less value than promised. Real study, real finding, wrong audience. It looked at 5,400 projects carrying price tags above $15 million, a category that covers government platform rebuilds and multinational ERP replacements, and nothing whatsoever that a 90-person distribution company running out of a single building would recognize. Your failure mode is smaller and more boring. One unplanned replacement jumps the queue in Q1 and eats the year.

What Is an IT Roadmap?

An IT roadmap is a dated, costed list of the technology work your business will do over the next 12 to 36 months, ordered by what the business needs and what will break first.

It's an internal document. The audience is your leadership team, your finance lead, and whoever signs off on capital spending. Not customers. Not the market. A product roadmap tells the outside world what's coming. An IT roadmap tells your CFO what's about to hit the checkbook, and when.

Think of it as connective tissue between two things you already have. On one side, business goals. Open a second facility, add a night shift, land a defense contract. On the other side, an environment full of servers, switches, licenses, and applications with expiration dates attached to them. The roadmap is what turns that first list into a funded, dated sequence of projects against the second, which is exactly why it can't be built by someone who only knows the technology or only knows the business plan. Where companies get this wrong is treating it as an IT artifact. It isn't. It's a spending plan that happens to be about technology.

What Goes on a Real Roadmap?

Four columns. Every line needs all four, or the line doesn't belong on the page.

The item. Why it's on the list. When it happens. What it costs. Drop any one of those and the document turns into a wish list, and wish lists get ignored the first time cash gets tight.

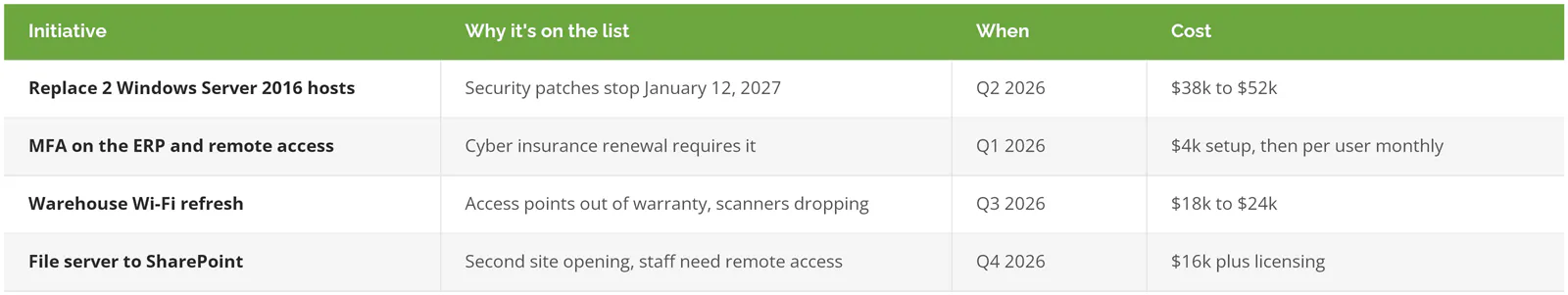

Four-column roadmap table showing initiative, reason, timing, and cost for a mid-market company

Those dollar figures are illustrative, not a quote. The point is that every row carries one. Gartner expects worldwide IT spending to reach $6.37 trillion in 2026, with IT services alone crossing $1.87 trillion, and none of that number does a single thing for you until it's broken down into individual lines your CFO can approve, defer, or kill outright.

Roadmap, Budget, Strategy, Governance. What's the Difference?

These four terms get used interchangeably, and they don't describe the same document. Confusing them is how a leadership team ends up with a strategy nobody funded and a budget nobody sequenced.

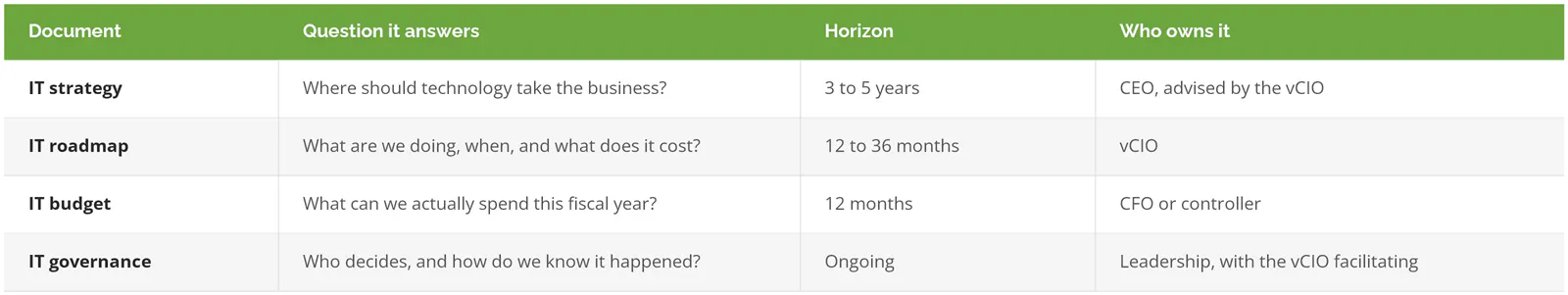

Comparison chart separating IT strategy, IT roadmap, IT budget, and IT governance

Governance is the one that gets skipped. It's also the one that decides whether anything on the roadmap happens. A 2010 European Journal of Information Systems study of small and midsize firms found that differences in steering committee structure and communication policy explained differences in IT outcomes across companies that otherwise looked alike on paper, right down to the size of their environments and the tools they had already paid for. Same tools. Different results. What separated them was who sat in the room and how often the room met.

How Does a vCIO Actually Build One?

Six steps, and the order matters more than the speed. Skipping the first one wrecks everything downstream.

Isometric diagram of the six-step process a vCIO follows to build an IT roadmap

1. Start With What You Actually Have

Nobody can sequence work against an environment they haven't counted. That means a real inventory. Every server with its operating system version and warranty end date, every switch and firewall, every application and the version it's running, every user account including the ones belonging to people who left in 2023. A proper IT assessment takes 2 to 4 weeks for a company in the 20 to 500 user range. Skip that count and the roadmap becomes fiction wearing a schedule, because every date on it rests on an assumption about equipment nobody actually looked at. It's the same discipline as learning to look at your infrastructure the way a vCIO does, applied at company scale.

2. Get the Business Goals in Writing

Ask leadership where the business is going over the next 3 years. Then write it down and read it back to them. Second facility in Q3. Headcount from 80 to 130. Chasing defense subcontract work, which drags CMMC certification along behind it. Every one of those carries a technology bill, and the bill arrives on schedule whether or not anyone wrote it down, which is the entire reason this step comes before anybody starts pricing hardware.

What you're listening for is timing. A company opening a second site in 9 months has a network project, not a network preference.

3. Build the Risk Register

What breaks the business if it stops? Not what's annoying. What stops revenue. A business impact analysis gives you that list in order, and the order is rarely what people expect. The ERP everyone complains about often matters less than the shared drive nobody thinks about, because the shared drive is where the drawings live and the shop floor can't cut metal without them.

4. Sort Into Three Lanes

Everything on the list belongs in one of three lanes.

  • Keep the lights on. Replacements, renewals, patching, the unglamorous work that carries a date whether you like it or not.
  • Reduce risk. Multi-factor authentication, which means requiring a second proof of identity beyond a password. Backup testing. Network segmentation, meaning splitting the network so a problem in one area can't reach the rest. These are the controls your cyber insurer is going to ask about at renewal, in writing, on a form where a no turns into either a higher premium or a declined application.
  • Enable growth. New site, new ERP module, automation, the AI pilot your board keeps raising. CompTIA's 2026 outlook put 84% of organizations on track to increase AI investment across 1,012 respondents, so that last one is landing on more boards than it used to.

Lane one quietly eats the budget. That's normal, and it's fine, as long as you can see it happening. A leadership team that runs the math and finds most of its technology spend is replacement work usually stops asking why nothing new ever ships.

5. Put Dollars on Every Line

A roadmap without cost estimates is a conversation, not a plan. Ranges are fine. A range of $30k to $45k for a server refresh beats no number at all, because it tells your CFO whether it's a this-year item or a next-year item. Our free IT budget tool covers the categories mid-market plans forget, and the two that go missing most often are licensing true-ups, meaning the back-bill you get when your user count crept past what you're paying for, and the labor to actually run the project.

6. Review It Every Quarter

Quarterly is the standard cadence for a reason. Things move. A vendor shifts a support date, a deal closes early, a competitor gets breached and suddenly your board cares about segmentation. The quarterly review isn't a status meeting. It's a re-sequencing meeting. What moved up, what moved down, what got funded, what got cut, and why.

What Forces Items Onto the Calendar?

Some roadmap items are choices. Others are dates on someone else's calendar that you don't control, and those set the shape of the year before you pick anything.

  • Vendor end-of-support dates. Microsoft ends extended support for Windows Server 2016 on January 12, 2027. No security patches after that, and extended security updates cost real money. Two of those hosts still in your rack? That's a funded project with a hard deadline, not a maybe.
  • Warranty and lease expirations. Hardware past warranty is a full-price emergency repair bill waiting for a bad Tuesday.
  • Compliance deadlines. CMMC assessment windows, SOC 2 audit periods, PCI attestation dates. These have fixed calendars and long lead times.
  • Cyber insurance renewal. Carriers now ask for named controls on the application. Answer no on enough of them and the premium moves, or the policy doesn't get written.
  • Your own growth. A signed lease on a second building is an IT project with a move-in date attached.

Put those dates on one calendar before sequencing anything discretionary. They're the fixed points. Everything else moves around them.

Where Roadmaps Fall Apart

Four failure modes, in rough order of how often they turn up.

No owner. The roadmap exists, it's accurate, and no name sits next to any line. Q1 passes. Nothing moves. A line item without a named human is a suggestion.

No dollars. Covered above. Worth saying twice. Finance can't defer what it can't price.

Never reviewed. Built in January, opened again in November to explain why it didn't happen. By then it's a post-mortem with a nicer title.

Lane-one creep is the subtle one, and the one that quietly kills the most plans. Deferred replacements pile up, a bigger share of the budget goes to catching up on equipment that should have been replaced two cycles ago, and the plan slowly stops being about where the business is headed and starts being about what's already broken. That's how technical debt shows up in budget planning, and it compounds quietly until a year arrives with room for nothing but replacements. The roadmap is real at that point. It's just entirely defensive.

Skip This If Your Environment Is Small Enough

Under 20 users, everything running in Microsoft 365 or Google Workspace, one location, laptops instead of servers, no compliance obligation? You don't need a formal roadmap. A shared spreadsheet with renewal dates and a replacement year for each laptop covers it. Formal planning at that size costs more attention than it gives back.

The math changes fast, though. Somewhere between 20 and 50 users, companies tend to pick up a server, a line-of-business application, a compliance requirement, or a second site. Three of those four at once is the point where the spreadsheet stops working.

What to Do With This

Two things worth keeping. A roadmap is a spending plan with dates on it, not a slide with colored bars, so if it doesn't say what each item costs and who owns it, it isn't one yet. And the fixed dates set your sequence. Vendor support windows, warranty expirations, and audit deadlines decide most of the calendar before you ever get to the projects you actually want to run.

We build and maintain these plans at Consilien for companies with 20 to 500 users, largely in manufacturing, distribution, professional services, and real estate. The work is translating technology decisions into business decisions a leadership team can act on, which is what a vCIO engagement exists to do. If you're weighing whether to build that capacity in-house instead, the comparison worth running is a virtual CIO against a full-time hire, and the answer usually turns on your growth curve rather than your headcount.

Have a Roadmap You're Not Sure Is Real?

Run it against the four columns. If half the lines are missing a cost or an owner, that is where to start. We can also walk the environment first and build the list from what is actually there.

Questions Executives Ask About Roadmaps

How far out should a roadmap actually go?
12 months in detail, 36 in outline. Past 3 years you're guessing, because hardware cycles, vendor support windows, and your own growth plan all shift underneath the estimate. The 12-month portion carries costs and owners on every line. The outer years carry categories and rough ranges, which is enough for a CFO to plan around without pretending to a precision nobody has, and that distinction matters more than it sounds, because a roadmap claiming three-year accuracy gets written off as fiction the first time year two doesn't match.
Our MSP already sends a quarterly deck. Is that a roadmap?
Sometimes. Check two things. Does every line carry a dollar figure, and does every line carry a name? A deck listing projects with neither is a status report wearing a roadmap's clothes. Useful for visibility. Useless for planning.
Who needs to be in the room when it gets built?
Whoever controls the money and whoever knows the business plan. In practice that's the CEO or COO, the CFO or controller, and the vCIO, with department heads pulled in for their own sections. Keep it small. An 11-person roadmap session produces consensus, and consensus isn't the same thing as sequencing.
What does it cost to have someone build one?
Rarely a separate invoice. Roadmap development sits inside a vCIO engagement for nearly every provider that offers one, so you're buying the ongoing advisory relationship rather than the document. Standalone assessment-and-roadmap projects do exist and get priced by environment size and complexity. The number worth watching isn't the fee anyway. It's the gap between planned replacement and emergency replacement, because emergency work carries expedited shipping, after-hours labor, and whatever the downtime cost you while everyone stood around waiting on a part.
Can we just build one ourselves?
Yes, and some companies should. If you have an IT manager who understands the business side and gets protected time to do the planning, an internal roadmap works fine. It breaks when that same person is also closing tickets, because planning loses to the queue every single time.
